Alta Parking Lot Expansion
Welcome to Black Leaf Design.
We are a full-service design-build general contractor specializing in steel building projects from concept through completion. We believe strong communication creates successful projects and partnership, which is why this webpage serves as your dedicated project hub — providing clear visibility into design, budgeting, plans, schedules, and approvals for your entire project.
Project Details
Permit Number: Not assigned yet
Zoning: Commercial
Address: Alta Ski Area, Alta, UT 84092
General Contractor: Black Leaf Design LLC
President: Jared Grant
C: (517) 643-2100 E: jared@blackleafut.com
Goals
Manage and facilitate the north side expansion of the Wildcat parking lot.
Excavation and extraction of dirt from the lot. Trenches and hole for dropbox and wingwall.
Installation of retaining wall, dropbox and wingwall.
Level new parking area and backfill wall.
Paving of new area.
Building code Standards
2021 International Building Code (IBC)
2021 International Residential Code (IRC)
2021 International Plumbing Code (IPC)
2021 International Mechanical Code (IMC)
2021 International Fuel Gas Code (IFGC)
2020 National Electrical Code (NEC — NFPA 70)
International Energy Conservation Code (IECC):
2015 IECC for residential (in many jurisdictions under MSD)
2021 IECC for commercial construction
2021 International Existing Building Code (IEBC)
1. Project Overview
This plan outlines the proposed expansion and paving of an existing parking lot area at Alta Ski Area. The intent of the project is to improve parking capacity, durability, and drainage performance while maintaining compatibility with surrounding terrain and infrastructure.
The expanded parking area will be designed to safely manage surface runoff, control erosion, and ensure long-term structural stability in a mountain environment.

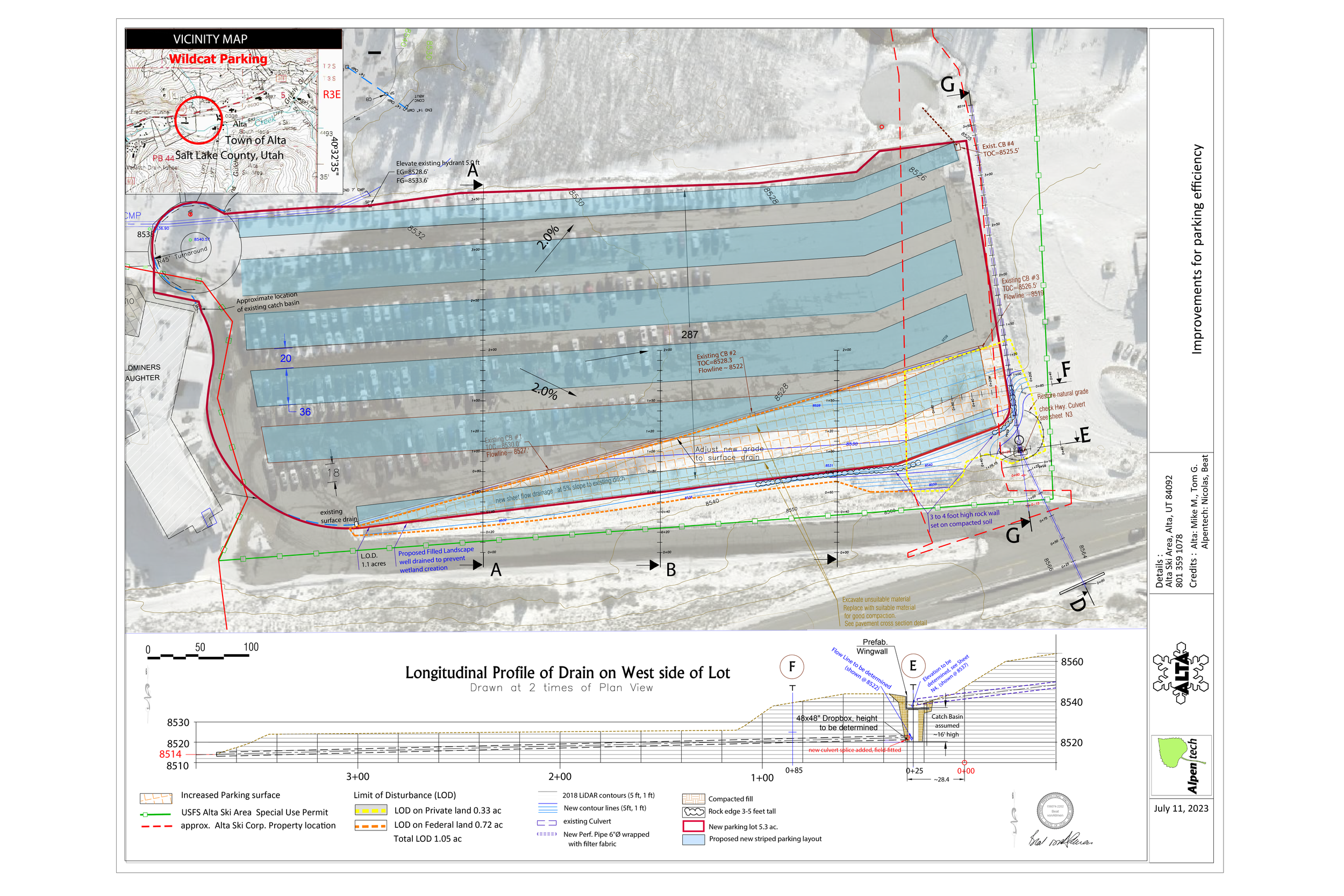

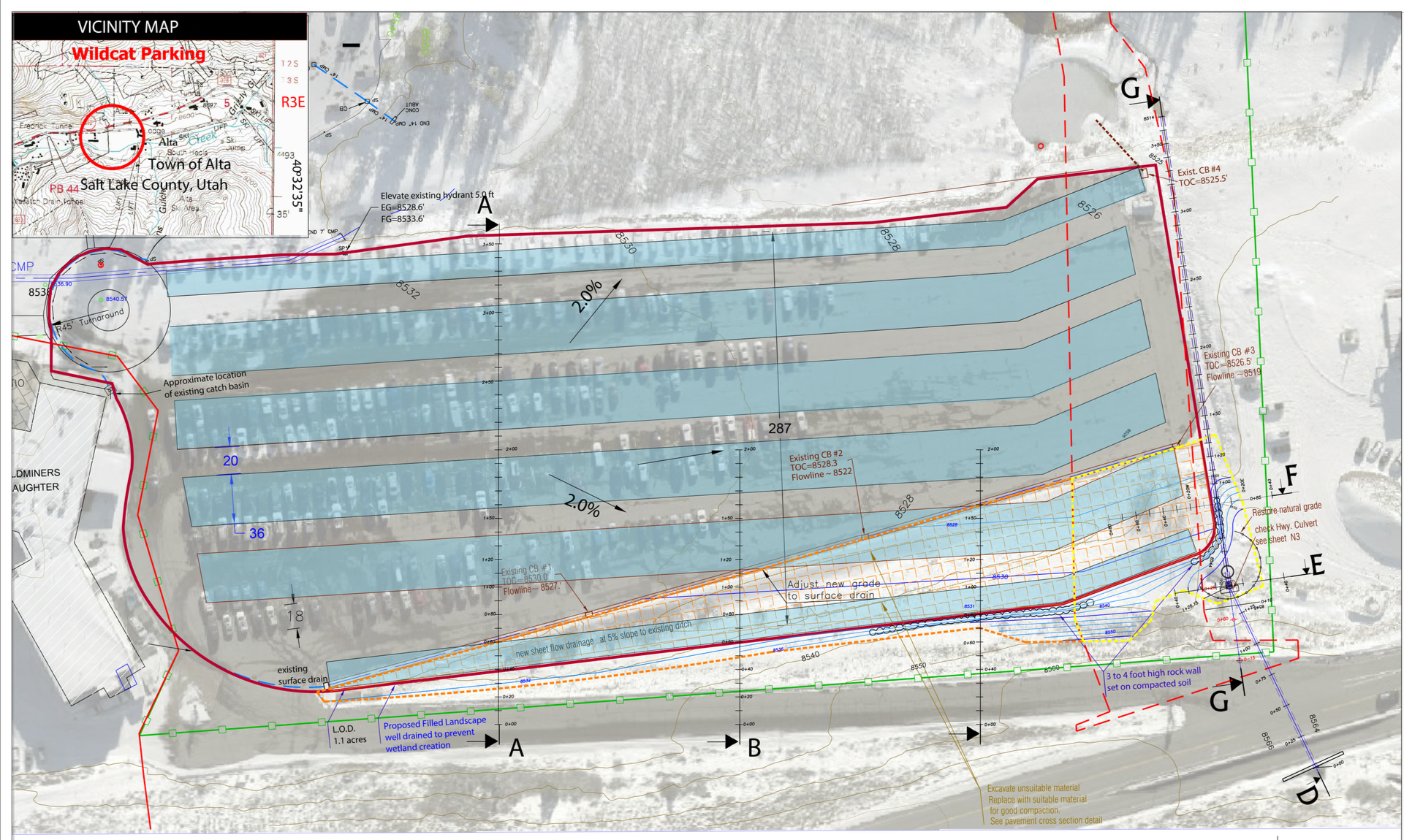

2. Grading & Drainage Plan
The expanded parking surface will be graded to maintain a consistent 2-degree slope across the paved area. This slope is designed to promote positive drainage, prevent ponding, and direct stormwater toward designated collection points.
Final grades will be tied into existing pavement and surrounding ground elevations to ensure smooth transitions and safe vehicle movement.

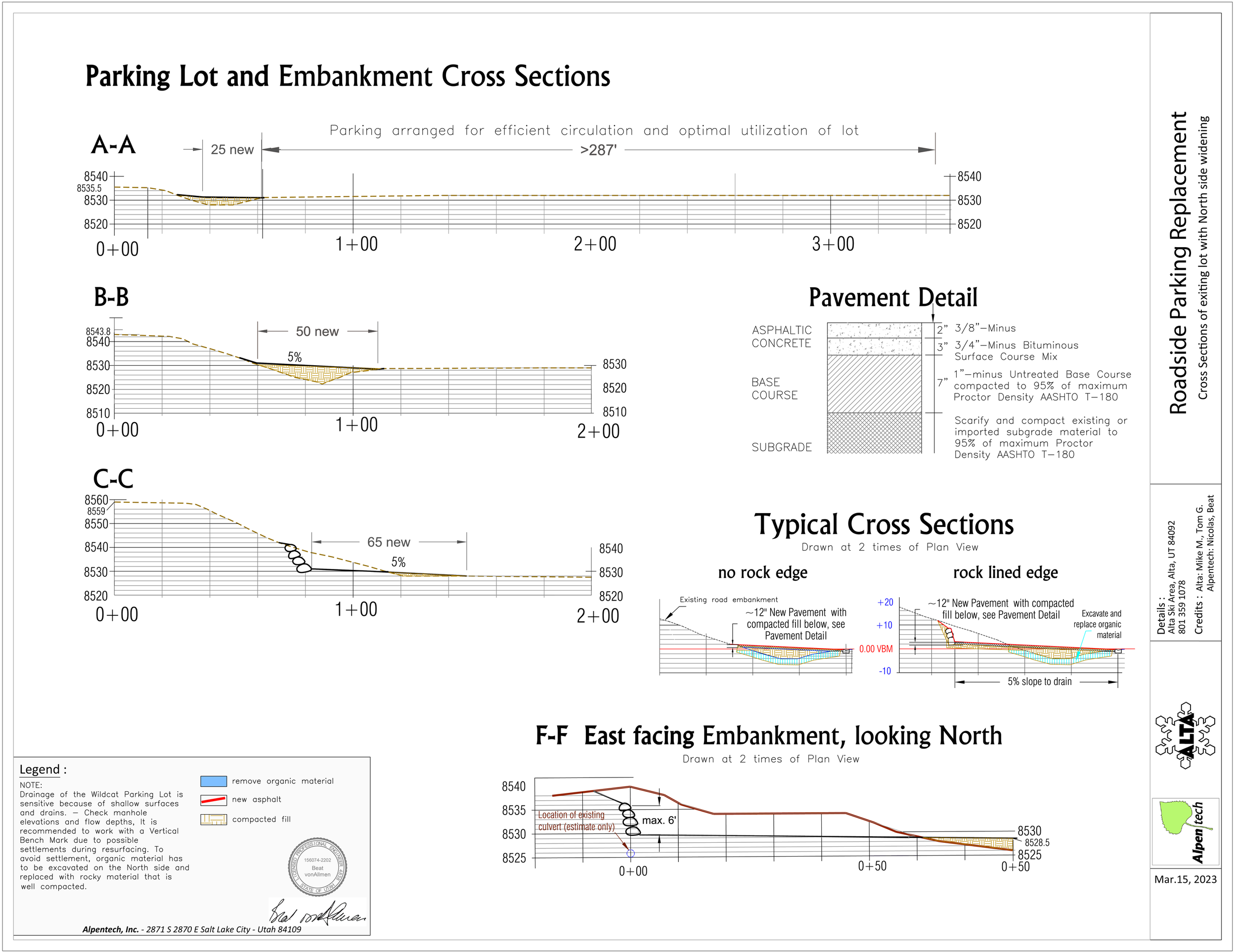

3. Retaining Wall - North Side
A retaining wall will be constructed along the north side of the expanded parking area to retain adjacent grades and maximize usable paved space. The wall will be designed to accommodate site-specific soil conditions and loading requirements.
The retaining wall will also assist in controlling runoff and preventing slope instability in this area.
4. Stormwater Management

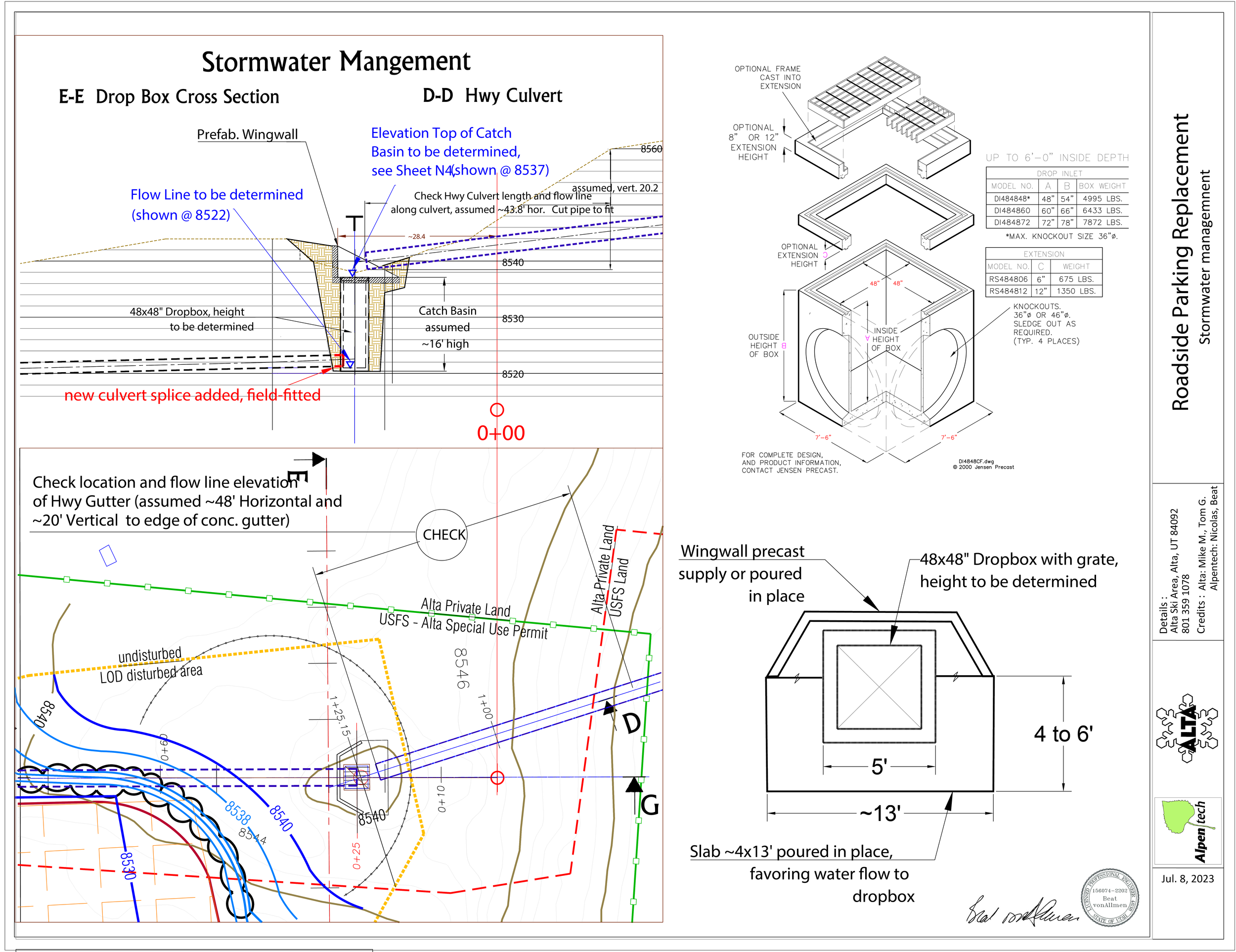

A complete stormwater management system is included as part of this plan. Surface runoff from the paved area will be conveyed to a precast concrete drop box, designed to collect and direct flows efficiently.
A precast wingwall will be installed at the outlet to provide structural protection, guide flow, and reduce erosion at discharge points. The system is designed to handle anticipated storm events and comply with applicable local and site-specific requirements.

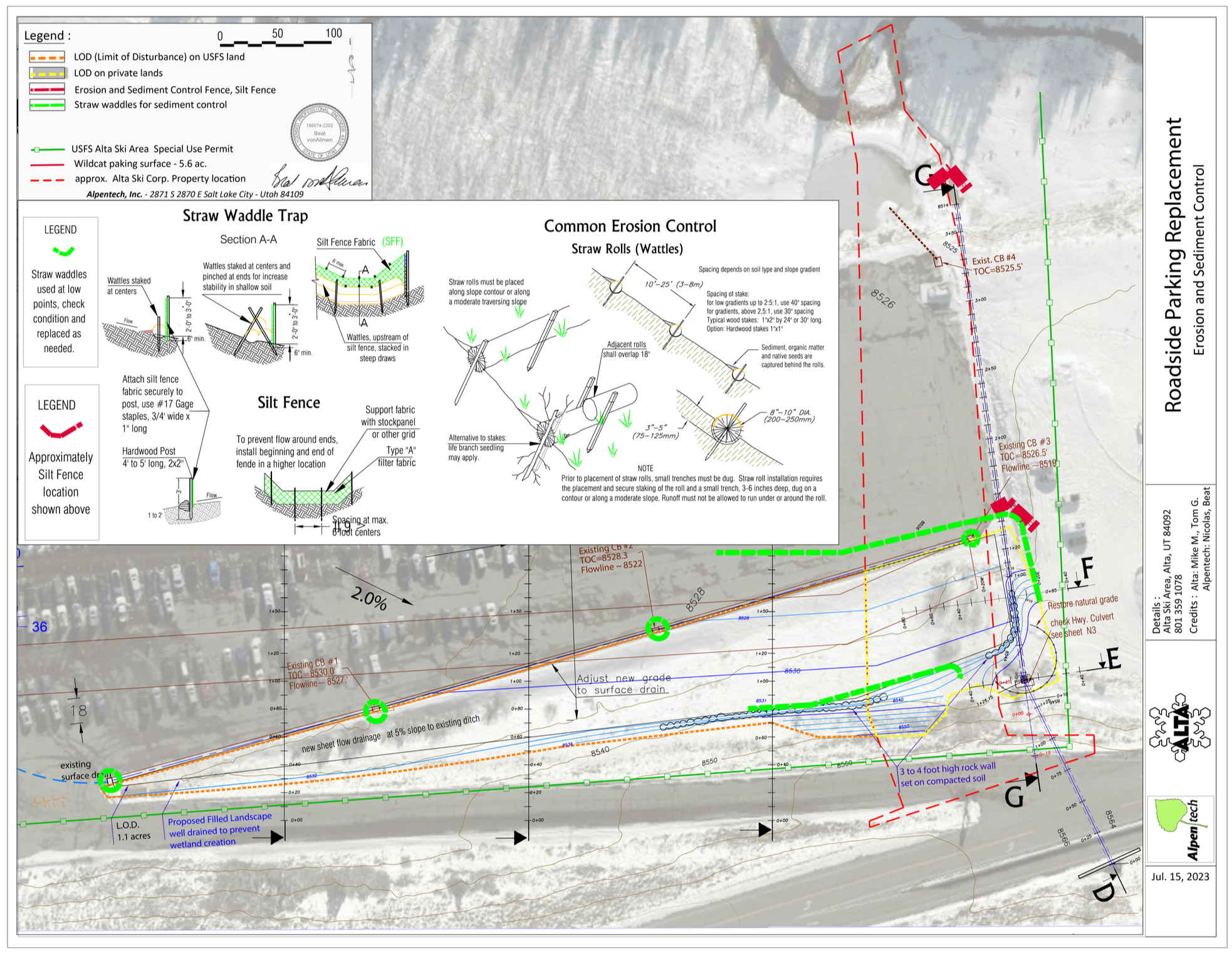

5. Erosion Control Measures
Erosion control measures will be implemented throughout construction and maintained until the site is fully stabilized. These measures may include, but are not limited to:
Silt fencing or equivalent perimeter controls
Stabilized construction access points
Temporary surface protection during grading
Final stabilization following paving and wall installation
All erosion control practices will be installed in accordance with standard best management practices (BMPs) for mountain and high-runoff environments.
Plans
Rough Project Schedule & Timeline (3 Months)
Month 1: Preconstruction, Earthwork & Wall Prep
Weeks 1–2
Mobilization and site setup
Install erosion control measures (silt fence, inlet protection, stabilized access)
Survey staking and layout
Initial clearing, stripping, and excavation
Rough grading of the expanded parking area
Stockpiling and export of excess material
Weeks 3–4
Continued excavation and subgrade preparation
Foundation preparation for north-side retaining wall
Begin retaining wall install
Stockpiling and export of excess material
Milestones:
- Erosion control in place
- Subgrade established
- Retaining wall construction underway
Month 2: Structural Work & Drainage Infrastructure
Weeks 5–6
Complete retaining wall construction
Install stormwater infrastructure
Precast drop box preparation
Precast wingwall
Connect stormwater system to existing drainage
Weeks 7–8
Backfill and compact behind retaining wall
Fine grading to establish 2-degree slope for drainage
Proof rolling and subgrade corrections as needed
Milestones:
- Retaining wall complete
- Stormwater system installed
- Final grades established
Month 3: Paving, Finishing & Stabilization
Weeks 9–10
Aggregate base placement and compaction
Final surface grading
Paving operations
Weeks 11–12
Final erosion control stabilization
Site cleanup and demobilization
Final inspection and punch list completion
Milestones:
- Paving complete
- Erosion control stabilized
- Project substantially complete
